How to Build and Design Your Dream Home in Ontario:
What the Process Actually Looks Like
Building a new house in Ontario takes longer than most people expect, and costs more than most budgets account for. The construction phase is only part of it. Before a single foundation is poured, there’s typically a year or more of design, approvals, and coordination that shapes everything downstream. Working with an architect who understands both sides of that equation: design, and construction – makes a meaningful difference.
Here’s a clear-eyed look at the procedure for building a house in Ontario.

The Design and Approval Process
One of the most common misconceptions about building a new house in Ontario is that the project begins when construction starts. It doesn’t. For most custom homes in Toronto, and across the province, the design and approval process runs twelve months or longer before a shovel hits the ground.
5 Stages of the Design and Approval Process
- Schematic Design. The first phase covers site analysis, room configuration, and how the building sits on the lot geometrically. This is where the logic of the home gets established: orientation, massing, flow.

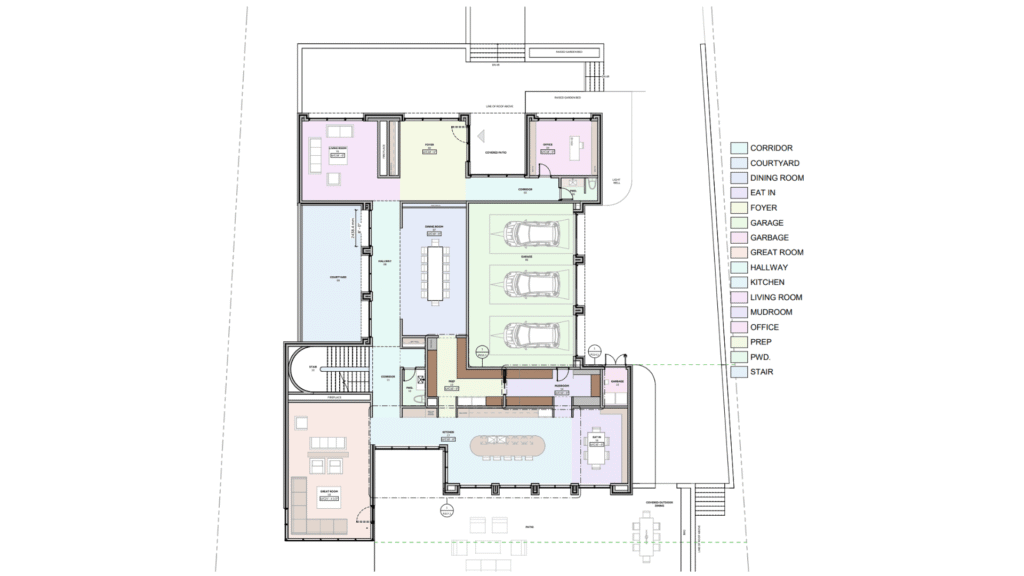

- Design Development. This stage moves into specifics: HVAC strategy, structural systems, and the beginning of the municipal process. Decisions made here affect cost, performance, and livability for the life of the building. This is also where interior room sizing and layouts are finalized, setting the foundation for everything that follows.

- Committee of Adjustment (if required). If the project requires a minor variance, which is relatively common in Toronto and other Ontario municipalities with tight zoning, this process alone can take four to six months. That window includes obtaining a zoning certificate, the hearing itself, and the ratification period that follows. The timeline for this stage also depends on when your municipality can schedule a hearing date, which can vary and may further extend the overall process.

- Conservation Authority Review. Properties near ravines, rivers, or the Lake Ontario shoreline often fall under the jurisdiction of a conservation authority such as the TRCA. These reviews address erosion, water management, and structural safety issues that directly affect the long-term integrity of the home. These authorities may also request additional reports or conduct their own investigations, which can prolong the timeline. It’s worth framing this as a layer of protection, rather than a roadblock.

- Building Permit and Construction Documentation. Full construction drawings are submitted for permit. This is the final gate before breaking ground. Timelines at this stage are also dependent on the availability and processing capacity of the City or municipality, and approvals can vary significantly. In some cases, the reviewing authority may request additional information, revisions, or clarifications, which can further extend the approval period.
Interior Design and Architectural Detailing
Interior design decisions: flooring species and thickness, ceiling types and heights, window heights, all need to be made earlier than most clients anticipate. These aren’t finish selections you can defer. They have to be built into the architectural drawings, and changing them later means revising structural or mechanical coordination.
At this stage, we are not yet selecting final decorative finishes like paint colours or wallpaper. Instead, the focus is on planning the hard surface materials to ensure proper coordination, accurate construction detailing, and a smoother overall build process.
A lot of this work involves reverse-calculation: starting from the desired finish and working backward through substrate, structure, and mechanical clearances to make sure everything lands where it should. When you’re aligning floor patterns with window mullions or coordinating ceiling coffers with HVAC returns, precision isn’t optional.
Cost to Build a House in Ontario
The cost to build a house in Ontario varies significantly by location and project complexity. Here are some general benchmarks for the Toronto area:
- $500-$700 per square foot (2026 CAD) is a realistic starting range for custom residential construction near Toronto.
- $1,000+ per square foot for luxury or technically complex builds. These figures are construction costs only and exclude design fees, permits, site work, and landscaping.
The primary cost drivers are building location and project complexity. One reliable way to manage budget: consolidate trades where possible. Reducing the number of different finishes and transitions not only controls the material costs but also limits coordination complexity across trades. In practice, having one contractor handle multiple related scopes reduces coordination overhead and often produces better results than fragmenting the work in the name of simplicity.

Building for the Long Term
A good architect in Ontario designs for more than the current occupant. That means thinking about life stages: future mobility needs, aging in place, potential multigenerational use. Features like elevator shafts don’t need to be built out on day one, but if the structural opening exists, adding them later is straightforward. If it doesn’t, it’s a major renovation. This kind of embedded flexibility is worth planning for.
Climate Responsive Design in Ontario
Ontario’s climate puts specific demands on residential construction that don’t apply the same way in milder regions. Thermal performance is the most significant variable, and glass, despite its appeal, has high thermal conductivity. That doesn’t mean limiting it. It means designing a building envelope where insulation values, wall assemblies, and HVAC systems are calibrated to work together.
On materials: locally sourced options are worth prioritizing. They’ve already been tested against Ontario weather cycles, and they tend to age better under freeze-thaw conditions. There’s also a practical case for staying within a material family – a masonry-forward exterior, for example, because it simplifies procurement and trades coordination without constraining the design.

Q&A: Common Questions About Building a House in Ontario
How long does it take to build and design a house in Ontario?
For a custom home, expect twelve to eighteen months of design and approvals before construction begins, plus twelve to eighteen months for the build itself. More complex projects, or those involving heritage review, TRCA approval, or Committee of Adjustment hearings can run longer.
What is the procedure for building a house in Ontario?
At a high level: hire your architect, complete schematic design, move through design development, navigate any required municipal or conservation authority approvals, obtain a building permit, and then begin construction. The municipal approval stage, particularly Committee of Adjustment (if needed) is the most variable in terms of timeline.
What does it cost to build a house in Ontario?
Near Toronto, construction costs typically start between $500 and $700 per square foot for custom residential work. Higher-specification and luxury builds run $1,000 per square foot and up. These are hard construction costs, professional fees, permits, and site work are additional.
When should interior design decisions be made?
Earlier than you think. Flooring, ceiling types, and window configurations all feed into the structural and mechanical drawings. If those decisions come late, the drawings have to be revised, which costs time and money. Ideally, key interior decisions are made during design development, before the permit set is finalized.
Does the TRCA slow down the process?
It adds time, but it’s not without purpose. TRCA review addresses erosion, water management, and structural safety for properties near natural features. For homeowners, that review is actually a form of protection—it catches issues that could become expensive problems after construction.
Working with FrankFranco Architects
FrankFranco Architects brings a contractor’s understanding of construction to the design process: a combination that matters when you’re managing costs, navigating Ontario’s municipal requirements, and building something meant to last. If you’re thinking about building a new house in Ontario, get in touch.
